Millennium Dome
Contents |
[edit] Introduction
The Millennium Dome (known as 'the Dome') is a fabric clad, cable net structure in Greenwich, London. It opened in 2000 as the centrepiece of the UK’s millennium celebrations, which ran from 31 December 1999 to 31 December 2000.
It was subsequently rebranded the O2 in 2005 and re-opened to the public in 2007, containing the O2 Arena, in 2008 it was heralded as the world's busiest music arena, and in 2012 it was used as the venue for the gymnastics as part of the London Olympics.
It continues to be used as a successful events space The O2 Arena, commonly now known as the O2, it is second only to the Manchester Arena in terms of seating capacity for an indoor venue and remains the ninth-largest building in the world by volume. The space now also houses shopping outlets, cinemas, restaurants and corporate event spaces alongside the venue space.
[edit] Storm Eunice
On February 18 in 2022 the UK was hit by Storm Eunice, which on the Isle of White set a new record of 122 miles per hour, for the fastest wind gust recorded in the region, was one of the most powerful storms to hit the south coast since 1987 and in London it tore parts of the roof off the Dome.
The Dome is made up of 72 segments, of which 8 were damaged by the storm leaving 6,000sq m of the roof-scape open and exposed. After just one week the majority of the venue could reopen, whilst a month later other outlets reopened, the roof was recovered temporarily whilst the original roof material was re-ordered. Due to the specialised material required lead in times were up to one year.
Alistair Wood responsible for overseeing the project to repair the damaged roof said at the time ' “There was nothing at all we could do on the February 18 so we reconvened the following day and the extent of the damage was quite frightening. It was a disaster rescue situation and we had to respond very quickly, which we did, making some very good, rapid decisions... Now we’ve been focusing on getting the venue waterproof and we want to be finished with that by Easter. Initially we’ll be installing a temporary roof that will be in place for the next year or two. That’s because the material – PTFE – is quite specialised and in quite high demand so there’s about a 12-month lead time on orders. Generally we’re pleased with how quickly we’ve been able to get going again but we’re not understating how harrowing that Saturday morning was."
[edit] Origins
A national celebration for the Millennium year in was originally conceived by John Major's Conservative government in March 1994. A consultation paper was published by the Millennium Commission in March 1995 and bids invited in May. Four sites were shortlisted, and in January 1996, creative communications agency Imagination Group were selected to develop ideas.
The Imagination proposal however was intended for the NEC site in Birmingham. Whilst this was logistically a very straight-forward site, and was more geographically central within the UK, the government felt that the Greenwich peninsular had more resonance with the theme, as it is crossed by the meridian line, and being in a deprived area of East London would benefit more from the investment that the millennium celebrations would bring.
Imagination were persuaded to move their proposal. However, being the site of a former gasworks and being very exposed, the Greenwich site brought with it its own problems. Architect’s Richard Rogers (now Rogers Stirk Harbour + Partners) and engineers Buro Happold proposed the idea of covering the site with a large fabric dome. This would create the shelter that would be required for a year long celebration that would open and close in the winter, and would allow the exhibition content to be constructed with relative freedom and in relative secrecy.
The New Millennium Experience Company Ltd (originally Millennium Central Ltd), was established to co-ordinate the design, construction and operation of the Millennium Dome and associated celebrations. The company issued a single share that was owned by the cabinet office minister (first Peter Mandelson and then Lord Falconer).
[edit] Design
At 320m in diameter, the dome is the largest single enclosed space in the world. It was constructed by McAlpine/Laing Joint Venture (MLJV), a joint venture formed between Sir Robert McAlpine and Laing Management.
The Dome is neither a true dome, nor a conventional fabric structure, it is a cable net structure, clad with flat fabric panels. The Dome is 52m at its peak, is supported by 12 masts 100m high and 72km of cables. It includes a large cut out section that accommodates a ventilation shaft from the Blackwall Tunnel.
The Dome fabric is a PTFE coated glass fibre fabric. There are in fact two layers of fabric, in order to provide some insulation between the inside and outside and to reduce the likelihood of condensation.

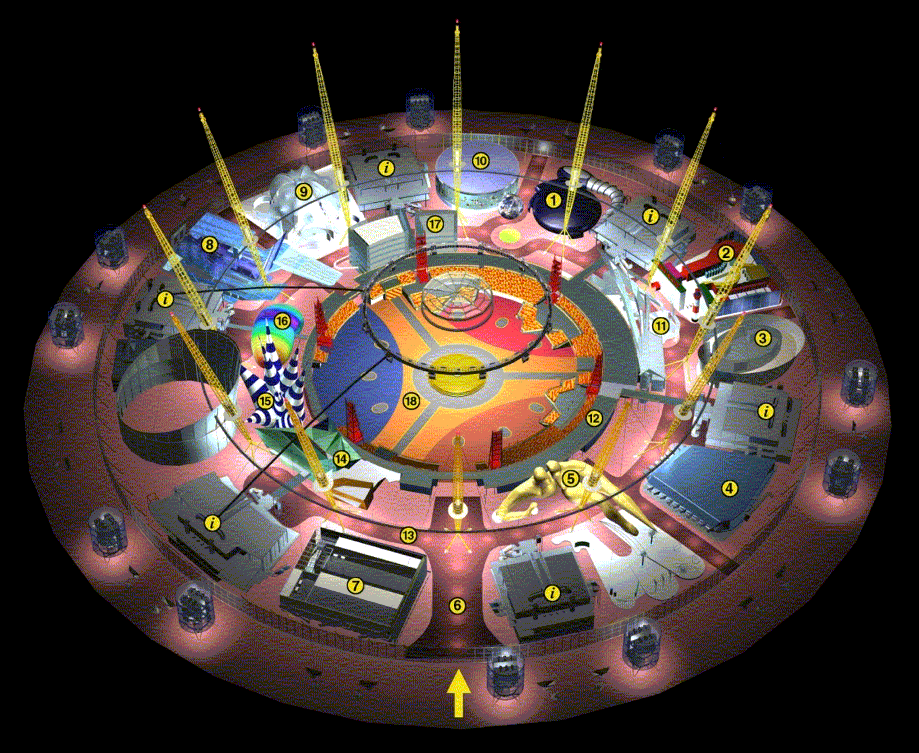

[edit] The zones
During the millennium year, the Dome contained a number of exhibitions or ‘zones’. The main zones fell under three categories, originally conceived as:
- Who we are: Mind, body and spirit.
- What we do: Work, rest and play.
- Where we live: Local, national and global.
These eventually became:
Who we are:
- Body. Sponsored by Boots, L'Oréal and Roche. Designed by Branson Coates Architecture.
- Mind. Sponsored by BAE Systems and Marconi. Designed by Zaha Hadid.
- Faith. Designed by Eva Jiricna Architects and Jasper Jacobs Associates.
- Self Portrait. Sponsored by Marks & Spencer. Designed by Caribiner and Pentagram.
What we do:
- Work. Sponsored by Manpower Inc. Designed by WORK.
- Learning. Sponsored by Tesco. Designed by WORK.
- Rest. Designed by Richard Rogers Partnership with lighting by Tanya Burns and sound by Artangel.
- Play. Designed by Land Design Studio.
- Talk. Sponsored by BT. Designed by Imagination.
- Money. Sponsored by the City of London. Designed by Caribiner and Amalgam.
- Journey. Sponsored by Ford. Designed by Imagination.
Where we live:
- Shared Ground. Sponsored by Camelot. Designed by WORK.
- Living Island. Designed by WORK.
- Home Planet. Sponsored by British Airways and BAA plc. Designed by Park Avenue.
Other installations and structures included:
- The Royal Mint.
- Timekeepers. Featuring Coggsley and Sprinx.
- Skscape. Showing a specially-commissioned film Blackadder: Back & Forth.
- The 1951 Festival of Britain Bus.
- The Millennium Star Jewels.
- The McDonald's Our Town Story. A stage on which each Local Education Authority in the UK was invited to perform their own show for one day only.
- Watercycle. Sponsored by Thames Water. Designed by IDEO.
- The Greenwich Pavilion. Designed by Richard Rogers, with content by David Bentheim and including a 3D animation of the Dome sponsored by Taylor Woodrow.
- Looking Around. An installation showing the view from the top of the Dome.
- The Hanging Gardens. Concealing ventilation shafts from the Jubilee line station.
- The Living Wall. Concealing the site accommodation and administrative offices.
- The Inhabited Island. Planting on the redundant ordinance pier.
- Quantum Cloud. An Anthony Gormley sculpture, engineered by Buro Happold.
- Meridian Point. An installation marking the passing of the meridian line across the site.
- The Red Boot. An on-site pub named in honour of Dome architect Mike Davies.
- Parabolic Waters. An Anish Kapoor installation that was quickly closed due to safety concerns.
- Slice of Reality. A section of a ship in the Thames by Richard Wilson.
- Spirit of Innovation. A showcase of millennium products, supported by the Design Council.
- Life Time. A Tony Cragg sculpture.
- Friday / Saturday. A sound installation by Tacita Dean.
[edit] The Millennium Show
In the centre of the Dome, there was a major performance area housing the Millennium Show, with seating for 5,000 and space for 7,000 standing spectators. The show, performed 999 times during the year of operation, was composed by Peter Gabriel, with staging by Mark Fisher, and performed by an acrobatic cast of 160 who were trained from scratch and went on to form the basis of the Generating Company, an international touring circus company.
[edit] Operation
The Dome attracted 6.5 million visitors during its year of operation, considerably lower than the 12 million projected. This was partly due to the fact that the Labour government gave away one million tickets to school children. These children might otherwise have come as paying customers and brought their families with them. Press coverage of the Dome also impacted on visitor numbers. Nonetheless, the Dome was the most visited building in the world in 2000, and had better visitor satisfaction numbers than Disney.
[edit] Controversy
During its development, the Dome was never very far from controversy, whether it was scepticism that it would be completed on time or in budget or about the content of the zones, through to detailed controversy about the environmental performance of the roof fabric, the nature of the Faith Zone, and whether the giant baby that formed part of the Body Zone should wear a disposable or re-useable nappy. The headline 'Dome' became a convenient hook for anyone with an agenda to publicise.
When the Dome opened for testing in December 1999 there was a temporary respite from the press onslaught as reviewers conceded that it would be completed on time, it had been completed on budget, and it did live up to expectations, with journalists quickly changing their positions. However, problems on the opening night proved disastrous. There were difficulties issuing invitations, and then there were insufficient security gates resulting in long queues to get in. Newspaper editors, not used to having to wait, took their revenge by reversing their position again and slating the Dome for the next 12 months.
Jennie Page revealed for the first time on Radio 4’s The Reunion in 2010 that there had in fact been a coded bomb warning on the opening night resulting in a serious security situation.
In February 2000, Jennie Page was replaced as Chief Executive by PY Gerbaux who took a more populist approach to operating the Dome.
In February 2017, it was reported that builders laying a cable had accidentally dug up and destroyed the Blue Peter time capsule that had been buried beneath the structure in 1998.
[edit] Sustainability
The Millennium Dome was the first major visitor attraction in the world not to have a car park. It was serviced instead by a new Jubilee line station, bus services and river ferries.
The Dome formed part of a ‘watercycle’. Rain water from the Dome roof was collected, filtered through reed beds in the landscape and used to flush the toilets. Waste from the toilets was then dried and burned to produce electricity which was used to power the Dome.
[edit] Related articles on Designing Buildings
- Architectural fabrics.
- Buckminster Fuller.
- Buro Happold.
- City Hall, London.
- Fabric structures.
- Frei Otto.
- Geodesic dome.
- Greywater recycling at the Millennium Dome.
- Lloyd's of London.
- Millennium Mills.
- Regeneration.
- Richard Rogers.
- Royal Albert Hall.
- Stadium.
- Ted Happold.
- The history of fabric structures.
- The development of structural membranes.
- The thermal behaviour of spaces enclosed by fabric membranes.
- Types of dome.
- Wembley Stadium.
- White elephant.
[edit] External references
- BBC The Reunion.
