Raising awareness of dewatering regulation
[edit] Introduction
Rules have changed around dewatering - excavating below the water table. What permits need to be in place before projects are started?

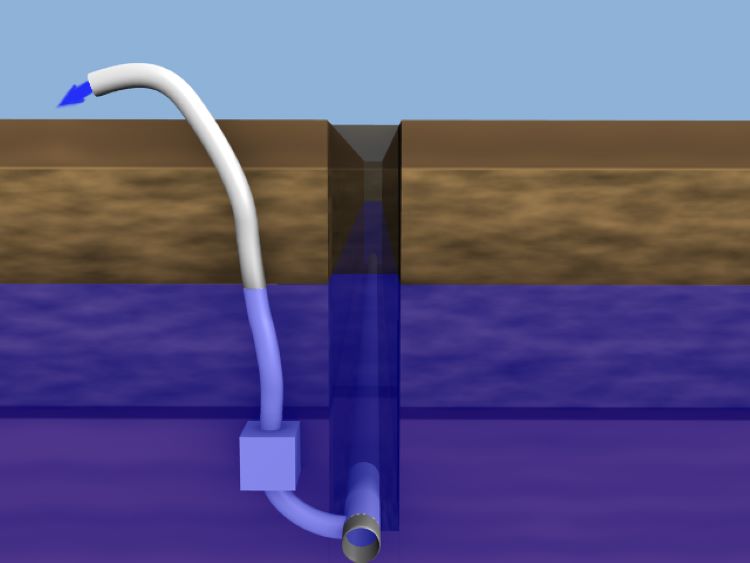

Groundwater lowering for construction (aka dewatering) is a common requirement for both small- and large-scale projects involving excavation below the water table. In the past, most dewatering was done without needing specific regulatory permission. That all changed in 2018, when dewatering was brought into legislation for England and Wales through amendments to the Water Resources Act 2003.
This means that many projects involving excavation below the water table now need approval (a Water Abstraction Licence) from the Environment Agency or Natural Resources Wales.
[edit] Raising awareness of dewatering changes
My experience is that some clients and contractors are unaware of the change in legislation or perhaps do not fully understand the timescale needed to prepare a robust application and obtain regulatory approval. This lack of awareness can have significant implications for project programme, and lead to unforeseen delays and costs.
The purpose of this article is to raise awareness of technical requirements and timescales of regulatory approvals for dewatering, including the requirements to obtain a Water Abstraction Licence and associated environmental permit to discharge the water.
[edit] Water Abstraction Licence
There are still exemptions for some small-scale dewatering activities. This includes sump pumping for less than six months duration and less than 100 cubic metres per day, provided the dewatering will not impact a protected site such as a site of special scientific interest (SSSI). When the duration or rates of dewatering exceed these limits, a Water Abstraction Licence will be needed.
The Water Abstraction Licence application includes a set of forms which are in themselves reasonably straightforward, requiring information such as company details of the applicant (usually the principal contractor) and anticipated dewatering rates.
[edit] What is the Hydrogeological Impact Appraisal?
The application must be supported by a Hydrogeological Impact Appraisal (HIA). Guidance on the content of the HIA has been provided by the Environment Agency.
In summary, the HIA should include a conceptual understanding of the groundwater system and a survey to identify water-related features that could be affected by the dewatering e.g. water supply boreholes, rivers and protected sites. The assessment is backed up by calculations of the dewatering rates and the predicted impact (groundwater level drawdown) on nearby water features. A tiered approach is taken, with the level of detail, time and cost depending on the sensitivity of the site (presence or absence of rivers, protected sites etc.) and the scale of dewatering.
For moderate-scale dewatering that's not in a highly sensitive area, simple calculations and logical arguments can be used to support the application. For sites where high dewatering rates are needed and/or in sensitive areas, the HIA may require extensive ground investigation, water features survey(s), pumping test(s) and stream/spring monitoring. This is likely to take several months.
Ground investigations need to be specified, tendered and delivered. Access to third-party land may need to be negotiated for water feature surveys. A pumping test may require a separate consent from the regulator, and the test may need to be several days or weeks long.
Stream and/or spring flow monitoring may need to be carried out over several months to capture seasonal variations. A numerical groundwater model may also be needed to assess the impacts with sufficient confidence to satisfy the regulator. Numerical groundwater models can be used to predict the effects of longer term and/or higher rates of dewatering where it is not practical to be tested directly by observation.
Once the HIA is completed and submitted, the regulator has up to four months to assess the application.
In cases where a third-party asset would be affected by dewatering, such as a private water supply spring or borehole, a written derogation or compensation agreement is needed prior to the regulator issuing a licence.
[edit] When an environmental permit will be needed
Many dewatering activities will also need an environmental permit to discharge the water to a river or other watercourse. This is a separate application and one that may require coordination between several teams; the principal contractor, specialist dewatering sub-contractor, hydrogeologists, hydrologists and perhaps aquatic ecologists.
Hydrogeologists estimate the dewatering rates and analyse the groundwater chemistry including potential contaminants. Hydrologists assess whether the receiving watercourse can accommodate the dewatering volumes. Aquatic ecologists and/or geochemists may be needed too if the receiving watercourse is sensitive to changes in flow and/or water chemistry.
Again, the level of detail, time and cost needed to complete the assessment will be determined by the environmental sensitivity of the receiving watercourse, the dewatering rate and if there are contaminants in the groundwater.
[edit] Why the right permits need to be in place
Small projects in particular can suffer proportionally large programme delays and cost overruns if the relevant regulatory permits are not in place. This is not in anybody’s interest, since many schemes are ultimately paid for by public money (e.g. taxpayers, water company customers etc.).
Some projects, such as road and railway cuttings, require permanent dewatering to prevent flooding or damage to infrastructure. The Environment Agency’s position statement describes situations when an Abstraction Licence is, and is not, needed.
In short, a licence isn’t needed if the water is transferred to a river or other watercourse by gravity without being pumped, and there are no significant impacts on protected sites or other water users. But in many cases, there still needs to be an assessment that demonstrates there will not be a significant impact. Again, this can lead to delay and unforeseen cost.
There can also be a perceived inconsistency where a project has planning approval, but further detailed assessment of dewatering may indicate unacceptable impacts. In this case, additional mitigation, or design change, may be required.
[edit] How to avoid project delays and problems
To avoid these problems, there may be scope for improvement on all sides.
Contractors and their advisors (consultants) need to allow time in their project programme to collect relevant data (ground investigation, water features surveys, pumping tests, spring/stream flow monitoring) and for the regulator to do its job in protecting the environment.
Early consultation with the regulator is strongly advised to discuss and agree the scope and duration of investigation and baseline monitoring. Regulators could request conditions at the planning application stage that stipulate a Water Abstraction Licence is needed for dewatering.
This would alert the client and contractor and trigger the assessment process to begin early in the project programme. Consultants also need to understand the practicalities of dewatering and have the skills to assess impacts on a range of environmentally sensitive features.
This article originally appeared on the Civil Engineer portion of the ICE website. It was written by Stephen Smith, Arcadis Consulting (UK) and published on 4 November 2021.
--The Institution of Civil Engineers
[edit] Related articles on Designing Buildings
- Dewatering construction sites.
- Environment Agency.
- Environmental impact assessment EIA.
- Groundwater.
- Groundwater control.
- Hydrogeological Impact Appraisal HIA.
- Hydrogeology.
- ICE articles on Designing Buildings Wiki.
- Legislative framework for building design and construction.
- Passive dewatering.
- Pumps and dewatering equipment.
- Sites of special scientific interest SSSI.
- Types of excavation.
- Water abstraction licence.
- Water derogation.
- Water impoundment licence.
- Water Industry Act 1991.
[edit] External resources
Featured articles and news
CIOB launches global mental health survey
To address the silent mental health crisis in construction.
New categories in sustainability, health and safety, and emerging talent.
Key takeaways from the BSRIA Briefing 2024
Not just waiting for Net Zero, but driving it.
The ISO answer to what is a digital twin
Talking about digital twins in a more consistent manner.
Top tips and risks to look out for.
New Code of Practice for fire and escape door hardware
Published by GAI and DHF.
Retrofit of Buildings, a CIOB Technical Publication
Pertinent technical issues, retrofit measures and the roles involved.
New alliance will tackle skills shortage in greater Manchester
The pioneering Electrotechnical Training and Careers Alliance.
Drone data at the edge: three steps to better AI insights
Offering greater accuracy and quicker access to insights.
From fit-out to higher-risk buildings.
Heritage conservation in Calgary
The triple bottom line.
College of West Anglia apprentice wins SkillELECTRIC gold.
Scottish government launch delivery plan
To strengthen planning and tackle the housing emergency.
How people react in ways which tend to restore their comfort.
Comfort is a crucial missing piece of the puzzle.
ECA launches Recharging Electrical Skills Charter in Wales
Best solutions for the industry and electrical skills in Wales.
New homebuilding skills hub launch and industry response
Working with CITB and NHBC to launch fast track training.
